Project

General

Profile

Gantt

Filters

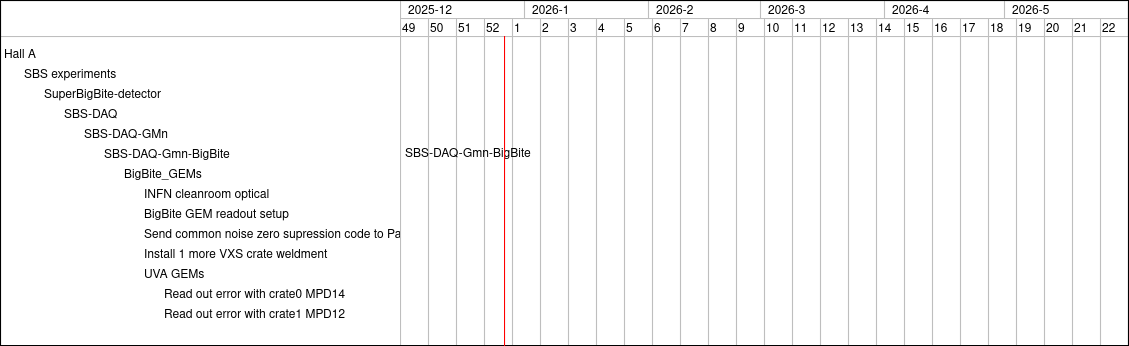

Zoom in Zoom out « April | June »

months from Apply Clear

Task #575: INFN cleanroom optical
Task #576: BigBite GEM readout setup
Task #583: Send common noise zero supression code to Paolo
Task #650: Install 1 more VXS crate weldment
Bug #597: Read out error with crate0 MPD14
Bug #598: Read out error with crate1 MPD12

Status

New
New
New
New
New
New

Priority

Normal
Normal
Normal
Normal
Normal
Normal

Assignee

Updated

09/11/2020 10:21 AM
09/11/2020 10:21 AM
09/11/2020 10:56 AM
07/15/2021 08:50 PM
10/23/2020 10:24 AM
10/23/2020 10:24 AM


19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39
40
41
42
43
44
SBS-DAQ-Gmn-BigBite
