Project

General

Profile

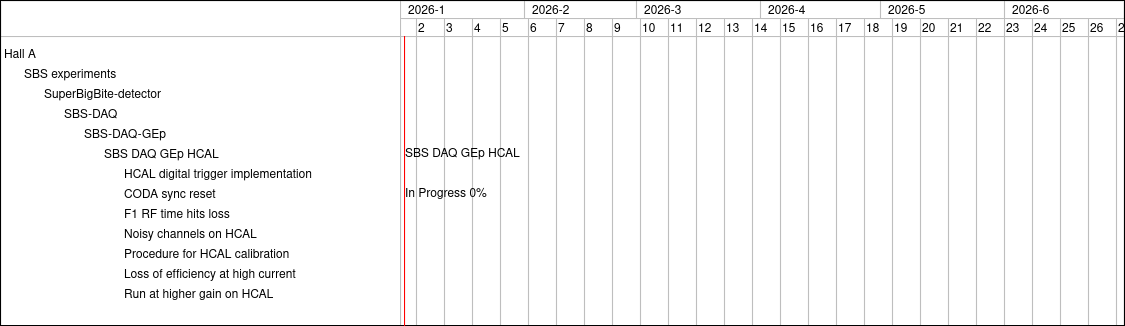

Gantt

Filters

Zoom in Zoom out « May | July »

months from Apply Clear

Task #1044: HCAL digital trigger implementation
Task #1045: CODA sync reset
Bug #1051: F1 RF time hits loss
Bug #1054: Noisy channels on HCAL
Task #1055: Procedure for HCAL calibration
Bug #1056: Loss of efficiency at high current
Task #1057: Run at higher gain on HCAL

Status

In Progress
In Progress
Resolved
In Progress
In Progress
New
New

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal

Updated

03/07/2025 10:12 AM
03/07/2025 10:08 AM
03/07/2025 10:09 AM
03/07/2025 11:26 AM
03/07/2025 11:26 AM
03/07/2025 11:24 AM
09/06/2024 11:34 AM

23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39
40
41
42
43
44
45
46
47
48
SBS DAQ GEp HCAL
In Progress 0%
