Project

General

Profile

Gantt

Filters

Zoom in Zoom out « April | June »

months from Apply Clear

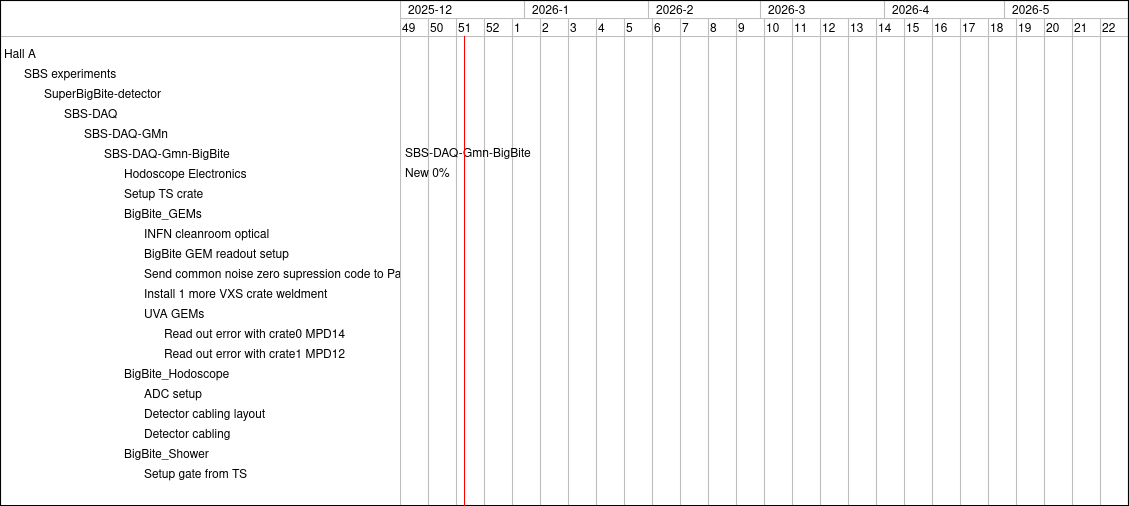

Task #393: Hodoscope Electronics
Task #579: Setup TS crate
Task #575: INFN cleanroom optical
Task #576: BigBite GEM readout setup
Task #583: Send common noise zero supression code to Paolo
Task #650: Install 1 more VXS crate weldment
Bug #597: Read out error with crate0 MPD14
Bug #598: Read out error with crate1 MPD12
Task #580: ADC setup
Task #581: Detector cabling layout
Task #582: Detector cabling
Task #592: Setup gate from TS
