Project

General

Profile

Gantt

Filters

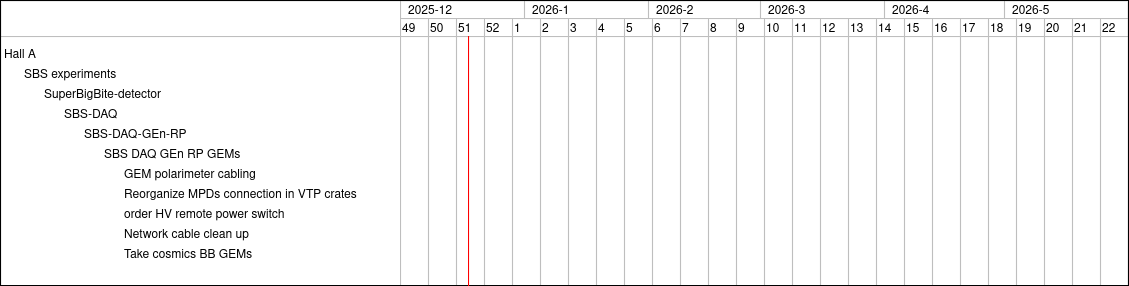

Zoom in Zoom out « January | March »

months from Apply Clear

Task #936: GEM polarimeter cabling
Task #938: Reorganize MPDs connection in VTP crates
Task #967: order HV remote power switch
Task #968: Network cable clean up
Task #969: Take cosmics BB GEMs

Status

In Progress
New
In Progress
New
New

Priority

Normal
Normal
Normal
Normal
Normal

Updated

02/21/2024 10:11 AM
02/21/2024 10:11 AM
03/06/2024 10:34 AM
03/06/2024 10:35 AM
03/06/2024 10:43 AM


6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31


Also available in: PDF PNG
