Project

General

Profile

Gantt

Filters

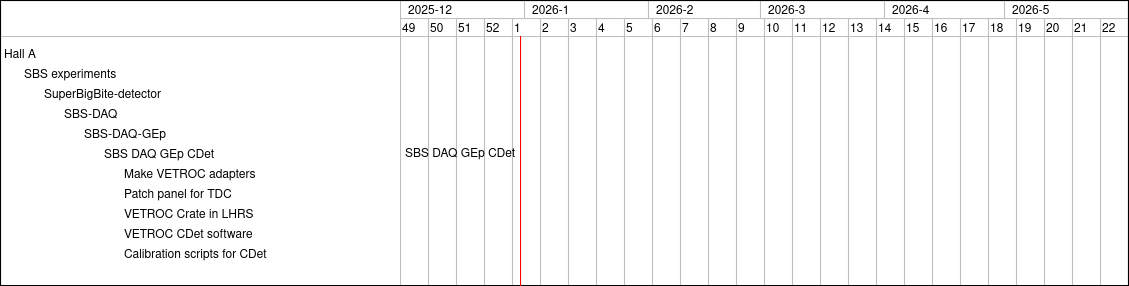

Zoom in Zoom out « January | March »

months from Apply Clear

Task #948: Make VETROC adapters
Task #983: Patch panel for TDC
Task #1058: VETROC Crate in LHRS
Task #1059: VETROC CDet software
Task #1060: Calibration scripts for CDet

Status

Resolved
New
Resolved
In Progress
In Progress

Priority

Normal
Normal
Normal
Normal
Normal

Updated

03/07/2025 10:11 AM
03/07/2025 10:10 AM
03/07/2025 11:24 AM
03/14/2025 11:43 AM
03/14/2025 11:42 AM


6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
SBS DAQ GEp CDet
